Portal Frame Steel Building Cost Optimization: Structural Sizing, Joint Detailing, and Erection Strategy

Value engineering in pre-engineered portal frames (PEB) requires balancing moment-resisting geometry, member cross-sections, and shop-to-site supply chain constraints. Reducing total installed cost without sacrificing lateral drift limits, serviceability, or building code compliance (such as AISC 360, Eurocode 3, or AS/NZS 4100) involves systematic optimization across structural geometry, joint configuration, raw material selection, and logistics.

David - Senior Structural Engineer at XinQiao Steel
David Senior Structural Engineer (PE) 10 Years Heavy Steel Experience

Specialist in industrial PEB detailing, AISC 360 connection design, and overseas turnkey project delivery at Shandong XinQiao Steel Structure Co., Ltd.

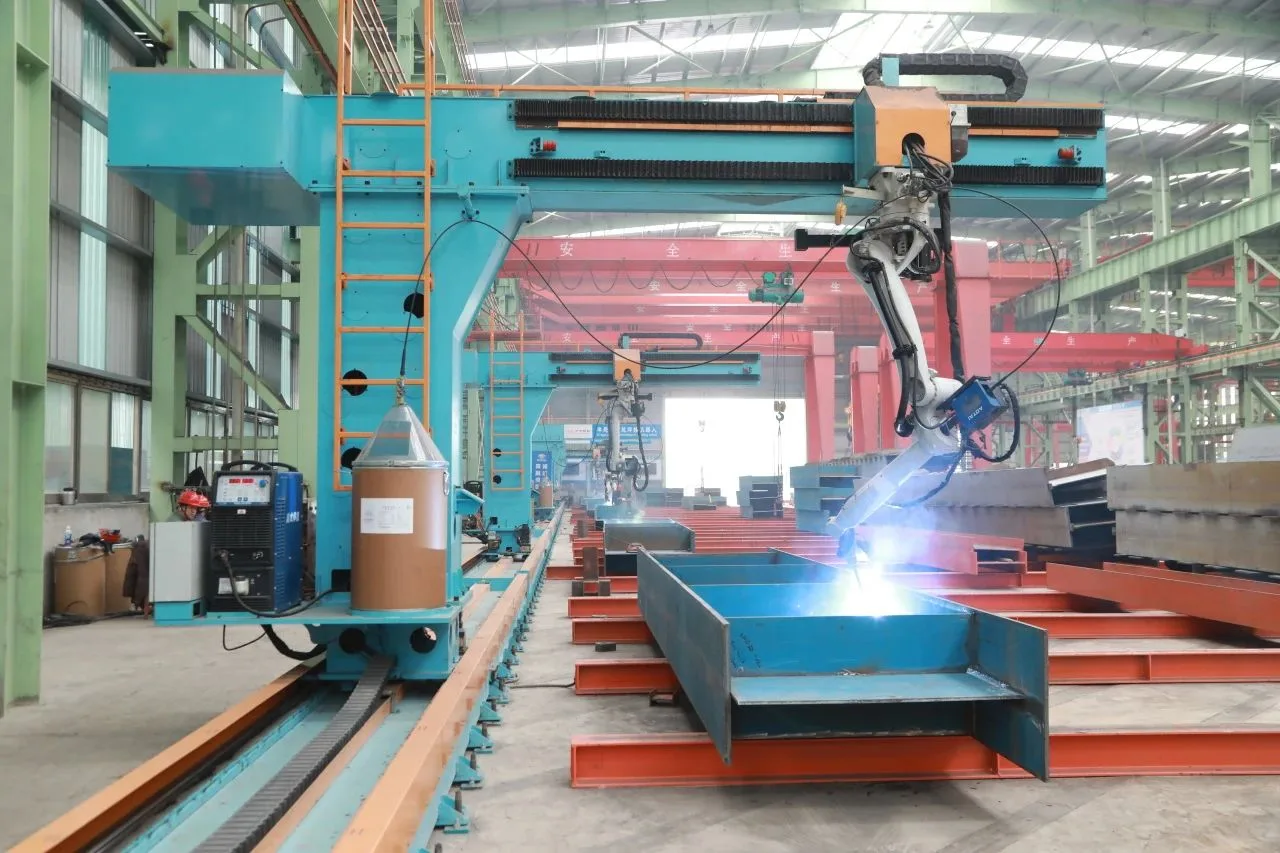

Automated SAW Welding and Fabrication of Tapered Built-Up Steel Portal Frames
Figure 1: Automated SAW welding and tapered built-up H-beam assembly for pre-engineered portal frame warehouses. PEB Optimization Protocol

1. Geometric Sizing and Grid Optimization

Structural economy begins with framing geometry. Incorrect primary framing grids cascade through secondary steel, concrete footings, and transport volume.

Economical Span
18m – 30m
Optimal at 24m (~25kg/m²)
Optimal Bay Spacing
8.0 Meters
Economic band: 7m – 9m
Eaves Elevation
Min Clear + 0.5m
+1m height = +2-3% steel
Roof Pitch
5% to 8%
Prevents ponding & uplift
  • ▪
    Clear Span Efficiency: For industrial facilities without overhead bridge cranes, the most cost-effective span ranges from 18 m to 24 m. For crane-yielding buildings (5–20 metric ton capacity), 24 m to 30 m represents the structural sweet spot. At a 24 m span, primary frame steel consumption drops to an optimal baseline of approximately 25 kg/m². Clear spans exceeding 36 m introduce non-linear stiffness penalties, driving up web depth and flange thickness rapidly. Systematic span optimization yields a 5% to 15% reduction in total steel consumption.
  • ▪
    Bay Spacing Mechanics: Practical bay spacing spans 7 m to 9 m, with 8 m representing the optimal baseline for industrial framing. Selecting bays under 7 m increases the total number of frames, connection plates, anchor bolt sets, and isolated footings. Spacing bays wider than 9 m increases bending moments on secondary roof purlins and wall girts, increasing secondary steel weight by 18% to 25% and negating primary frame savings. Calibrating bay spacing saves 10% to 20% in structural steel mass.
  • ▪
    Eaves Height & Pitch Calibration: Set the eaves height strictly to the minimum process or crane clearance plus 0.5 m. Every additional 1 m of vertical clearance adds 2% to 3% to frame steel weight due to elevated wind load moments and column buckling lengths (KL/r). Roof slopes should be held between 5% and 10% (5% for mono-pitch, 8% for gable frames), preventing both rain ponding and redundant wind-induced cladding waste.
Geometric Parameter Sub-optimal Framing Optimized Target Steel & Cost Impact
Clear Span (No Crane) < 15 m or > 36 m 18 m – 24 m 5% – 15% steel reduction
Bay Spacing < 6 m or > 10 m 8 m (7 m – 9 m range) 10% – 20% total steel savings
Eaves Clearance Operational clearance + 1.5 m Operational min + 0.5 m 3% – 5% structural cost reduction
Roof Slope < 3% or > 15% 5% (mono) / 8% (gable) 5% cladding material savings

2. Cross-Section Efficiency and Joint Detailing

Standard hot-rolled universal beams (UB) carry surplus steel mass along low-stress zones. Fabricated three-plate built-up members allow custom tapering that closely matches the bending moment envelope.

Rafter & Column

Tapered Built-Up Sections

Maximum web depth placed at high-stress haunches, tapering toward low-moment inflection points. Saves 10% to 15% steel over prismatic beams.

Tooling: Automated SAW multi-head submerged arc welding lines.
Knee & Ridge

Extended End-Plate Joints

Field-bolted moment connections replace field groove welds, cutting erection labor by 30%. Smooth 80mm transition radius lowers stress amplitude by 15%.

Code Standard: AISC 358 / EN 1993-1-8 bolted end plates.
Lateral System

Tension-Only Rod Bracing

Solid round bars with drop-forged turnbuckles replace heavy HSS hollow tubes in non-extreme seismic zones, cutting bracing weight by 15% to 20%.

Detailing: Sag rods spaced ≤ 6m to stabilize purlins.

3. Strategic Material Selection and Envelope Systems

Matching steel grades to governing limit states prevents over-engineering structural components while controlling fabrication and procurement lead times.

Governing Limit State Allocation
Primary: Q355B (Strength) | Secondary: Q235B (Deflection)
Utilizing Q355B saves 15%–25% member weight; Q235B prevents overpaying for stiffness-governed parts.
Fastener Benchmark Grade 8.8 (A325 HDG)
01
Continuous Nested Z-Purlins vs. Simple C-Girts: Specifying continuous cold-formed Z-sections over lapped joints increases flexural load capacity by 30% over simple-span C-sections, lowering secondary roof framing mass by 10% to 15%. Wall girts with single spans remain economical with standard C-channels.
02
Grade 8.8 (A325) Structural Fasteners: Where structural shear and tension calculations permit, adopt Grade 8.8 instead of Grade 10.9 bolts. This reduces hardware unit costs by 15% to 20% and eliminates hydrogen embrittlement risks associated with over-torqued galvanized assemblies.
03
Lightweight Enclosure & Isolated Footings: Single-skin 0.5mm profiled steel sheets with glass wool blanket reduce roof dead load by 80% compared to concrete slabs, cutting foundation sizing by 30%. On soil with bearing capacity qa ≥ 120 kPa, shallow pad footings save 40% to 60% over deep piles.

4. Fabrication, Container Logistics, and Erection Sequences

True cost reduction extends beyond raw steel calculations to cover workshop nesting, container packing, and field crane hours.

01

40ft High Cube Container Splice Detailing

Configure rafter and column segment lengths to ≤ 11.8 m and widths to ≤ 2.3 m with bolted splices. This fits steel directly into standard 40HC ocean containers, avoiding out-of-gauge (OOG) shipping penalties and cutting freight by 15% to 20%.

02

CNC Plate Nesting Efficiency (≥ 95%)

Standardize web depths to nominal steel plate widths (1,200 mm and 1,500 mm) on automated CNC cutting lines. Maintaining shop prefabrication ≥ 90% reduces raw scrap by 5% to 8% and slashes site labor by 50%.

03

Ground Pre-Assembly & Tandem Hoisting

Assemble pairs of rafters with purlins and bracing on the ground before lifting. Single-lift frame placement boosts crane utilization efficiency by 40% and cuts high-altitude labor costs by 25%.

04

Mobile Truck Crane Optimization

For clear spans ≤ 24 m, calibrate individual piece weights to allow mobile hydraulic truck cranes instead of heavy crawler cranes, lowering mobilization and daily equipment rental costs by 30% to 50%.

05

Disciplined Erection Sequencing

Erect the braced bay first to establish structural stability, followed by primary portal frames and secondary infill. This eliminates double handling and compresses site schedules by 15% to 20%.

5. High-Risk False Economies (The Engineering Pitfall Guide)

Cost reductions that compromise structural stability or durability generate severe financial and legal liabilities. Avoid these four common value engineering traps:

Critical Risk +20% Retrofit Cost

Blind Plate Thinning

Arbitrarily reducing web and flange thickness to lower tonnage results in excessive lateral drift and crane runway misalignment, requiring expensive on-site stiffener retrofits.

Governing Code: Must verify deflection limits (L/180 to L/240) alongside strength.
Collapse Hazard 3x Repair Expense

Omitting Bracing & Fly Braces

Eliminating compression-flange fly braces on rafters induces sudden lateral-torsional buckling (LTB) under wind uplift. Remediation costs exceed initial steel savings by 300%.

Safety Rule: Bottom flange fly braces must be installed at all hogging moment zones.
Material Defect -50% Service Life

Non-Certified Steel Coils

Procuring secondary non-mill-certified coils with unverified chemistry leads to weld lamellar tearing and premature fatigue failure under heavy industrial dynamic loads.

Traceability: Demand EN 10204 3.1 Mill Test Certificates (MTC) for all plates.
Durability Loss Rapid Delamination

Neglecting Surface Prep & Primer

Applying cheap primer over unblasted mill scale causes paint flaking within months. Sandblasting to Sa 2.5 is mandatory before applying any anti-corrosion barrier.

Compliance: ISO 8501-1 Sa 2.5 shot blasting + verified dry film thickness (DFT).

Technical FAQ: Portal Frame Optimization & Codes

Q1: Why are cold-formed Z-sections more cost-effective than C-sections for roof purlins?

Cold-formed Z-sections feature asymmetrical flanges with differing widths, allowing them to nest and overlap directly over intermediate portal frame rafters. This creates a continuous multi-span beam condition that provides up to 30% higher load capacity compared to simple-span C-sections of identical gauge, reducing total purlin tonnage by 10% to 15%.

Q2: How do 40ft High Cube container constraints dictate portal frame splice detailing?

A standard 40ft High Cube (40HC) ocean container has an internal clear length of 12.03 m, an internal width of 2.35 m, and a door opening height of 2.58 m. Detailing built-up rafters and columns with bolted end-plate splices at segment lengths ≤ 11.8 m and depths ≤ 2.2 m ensures components load directly into standard containers, avoiding costly open-top flat-rack surcharges and saving 15% to 20% in freight.

Q3: When should high-strength steel (e.g., Q355B / A572 Gr 50) NOT be used in a portal frame?

High-strength steel provides no weight benefit when member design is governed by stiffness or serviceability limits rather than material yield strength. Because steel's elastic modulus (E ≈ 205 GPa) is identical across all grades, members governed by strict lateral drift limits (e.g., Δ ≤ H/400) or crane runway deflections should utilize standard Q235B / A36 steel to satisfy the required moment of inertia at lower cost.

Q4: How does adjusting eaves height impact the overall cost of a portal frame building?

Increasing eaves height directly amplifies the wind load moment arm acting on the main columns and increases the effective column buckling length (KL/r). Each 1.0 m increase in clear height beyond operational requirements adds approximately 2% to 3% in total structural steel weight and expands wall cladding surface area.

Engineering Economics & Safety Assurance

Rational Value Engineering: How XinQiao Steel Cuts 15%–30% Costs Without Sacrificing Safety

True cost reduction in prefabricated steel construction is never achieved by blind plate-thinning or cutting structural corners—it requires rigorous value engineering grounded in international mechanics codes. When developing commercial logistics hubs or heavy crane workshops, owners need structural solutions that eliminate unnecessary tonnage while providing unconditional structural safety across a 50-year service life.

Backed by two decades of export engineering legacy, operating a 60,000 ㎡ heavy industrial steel manufacturing facility in Taian, China, XinQiao Steel (Shandong XinQiao Steel Structure Co., Ltd.) empowers EPC contractors and project owners with mathematical cost control:

Tapered Section Optimization Automated multi-head submerged-arc welding fabricates custom three-plate built-up members matching moment envelopes, trimming 10%–15% redundant steel tonnage over rolled beams while satisfying strict drift limits.
40ft High Cube Container Nesting Every rafter and column splice is calculated to fit inside standard 40HC containers (≤11.8 m segment length, ≤2.3 m width), eliminating open-top and breakbulk surcharges to save 15%–20% in freight.
CNC Plate Nesting (≥ 95%) Standardized web depths and automated CNC plate profiling achieve ≥95% raw plate material utilization, minimizing paid-for mill scrap and reducing fabrication overhead.
Dual Steel Grade Allocation Strategically assigning high-yield Q355B (A572 Gr. 50) to strength-governed primary frames and economical Q235B (A36) to deflection-governed secondary purlins prevents over-engineering and lowers material spend by 15%–25%.
100% Dry Bolted Site Assembly Sub-millimeter CNC multi-axis pre-drilled bolt holes guarantee 100% field bolted assembly. Eliminate on-site flame cutting and high-altitude welding to cut field erection timelines and crane costs by 40%–50%.
Strict Confidentiality & BOQ Audit Supported by 45+ licensed Tekla detailing engineers, we provide complimentary 24-hour structural review, bracing layout audits, and itemized Bill of Quantities (BOQ) under binding Non-Disclosure Agreements (NDA).
Back to Core Technology Overview Shandong XinQiao Steel Structure Co., Ltd. © 2026
